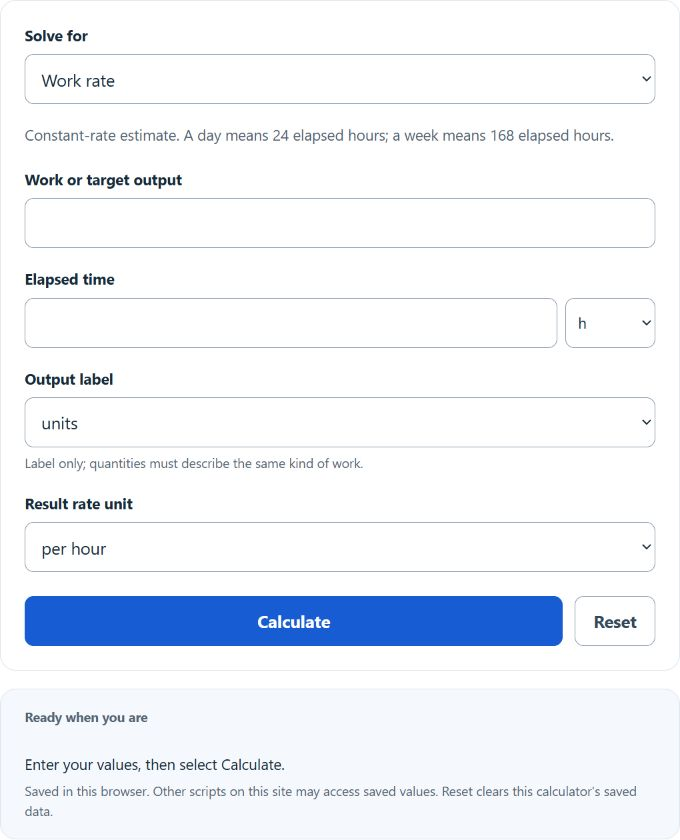

Calculate work rates, team completion time, production targets, and equivalent hourly, weekly, monthly, or annual pay rates from inputs.
- All Math and Numbers Calculators
- All Rate Calculators
- Piece Rate Calculator
- Labor Productivity Calculator
- Production Rate Calculator
- Tasks Per Hour Calculator
- Units Per Hour Calculator
Work Rate Formula
The calculator uses one core relationship in four forms, one for each tab.
Work ÷ Time (rate from output and time):
R = W / T
Together Time (two workers on one job):
T_together = 1 / (1/A + 1/B)
Production Target (solve for the missing variable):
W = R * T
Pay Rate (convert any pay period to hourly):
Hourly = Annual / (HoursPerWeek * 52)
- R = work rate (units per unit of time)
- W = total work or output (units, items, tasks, jobs, orders)
- T = total time spent
- A = time for Worker A to finish one job alone
- B = time for Worker B to finish one job alone
- T_together = time for both workers to finish one job together
- Annual = pay amount converted to a yearly figure
- HoursPerWeek = scheduled work hours in a week
Assumptions: rates are constant over the period entered, workers do not interfere with each other on the team tab, a year contains 52 weeks for pay conversion, and unpaid days reduce the annual equivalent proportionally to scheduled work days. Time inputs are converted to hours internally before any calculation, then converted back to your chosen output unit.
Each tab applies one form of the formula:
- Work ÷ Time divides output by elapsed time to give a rate per hour, per minute, and per day.
- Together Time adds individual rates (1/A and 1/B), then inverts the sum to get the joint completion time.
- Production Target takes any two of {output, time, rate} and solves for the third.
- Pay Rate normalizes any pay period to an annual figure, then divides by 52 weeks and your weekly hours to produce hourly, daily, weekly, and monthly equivalents.
Reference Tables
Use these as sanity checks when your inputs feel off.
| Time worked | Output | Rate (per hour) |
|---|---|---|
| 8 hours | 120 units | 15.0 |
| 8 hours | 240 units | 30.0 |
| 5 days | 1,000 items | 8.33 |
| 40 hours | 50 jobs | 1.25 |
| 30 minutes | 15 tasks | 30.0 |
| Worker A alone | Worker B alone | Together |
|---|---|---|
| 2 h | 2 h | 1.00 h |
| 3 h | 6 h | 2.00 h |
| 4 h | 6 h | 2.40 h |
| 6 h | 8 h | 3.43 h |
| 5 h | 10 h | 3.33 h |
Example Problems
Example 1: Work ÷ Time. A line packs 480 orders in 6 hours. Rate = 480 ÷ 6 = 80 orders per hour, or about 1.33 orders per minute. Each order takes 0.75 minutes.
Example 2: Together Time. Worker A finishes a job in 6 hours. Worker B finishes the same job in 8 hours. Combined rate = 1/6 + 1/8 = 7/24 jobs per hour. Together time = 24/7 ≈ 3.43 hours.
Example 3: Production Target. You need 5,000 items and your rate is 125 per hour. Time = 5000 ÷ 125 = 40 hours.
Example 4: Pay Rate. A $75,000 salary at 40 hours per week works out to 75000 ÷ (40 × 52) = $36.06 per hour. With 10 unpaid days off across a 5-day week (260 work days), the effective annual pay drops to about $72,115.
FAQ
What if my workers do not start at the same time? The Together Time formula assumes simultaneous work. If they overlap only partially, split the job into segments and use Work ÷ Time for each.
Can I mix units? Yes. Each input has its own unit selector. The calculator converts everything to hours internally, then back to your chosen output unit.
Why does the Production Target tab need one blank field? The formula W = R × T has three variables. Give it two and it solves for the third. Filling in all three or leaving two blank is ambiguous.
How are unpaid days handled in pay calculations? The hourly, daily, weekly, and monthly figures use your full schedule. The adjusted annual figure multiplies the annual pay by (work days − unpaid days) ÷ work days, which models lost income from unpaid time off.
Does this account for overtime or shift differentials? No. Enter the base rate. For overtime, calculate it separately at 1.5× or 2× the hourly result.
