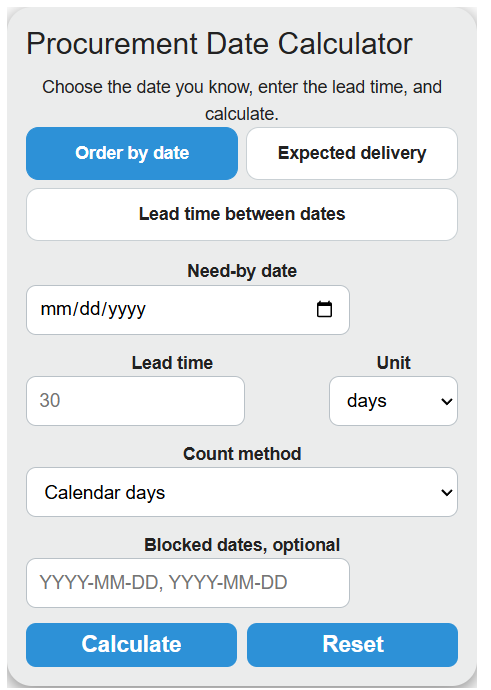

Calculate procurement dates, expected delivery, or lead time between dates using calendar or business days with optional blocked dates.
Related Calculators
- Days Of Supply Calculator
- Fill Rate Calculator
- Cost Per Unit Calculator
- Days Overdue Calculator
- All Business Calculators
Procurement Date Formula
The calculator runs three modes. Each mode uses a simple date arithmetic formula that accounts for either calendar time or business time.
Order by date mode:
Expected delivery mode:
Lead time between dates mode:
Variables:
- Need-By Date: the date the item, materials, or bid response must be in hand.
- Order Date: the date the purchase order is released or procurement starts.
- Delivery Date: the date the goods or services are expected to arrive.
- Lead Time: the duration between order release and delivery, expressed in days, weeks, months, or years.
- Start Date and End Date: any two dates you want to measure between.
Assumptions: calendar-day mode counts every day, including weekends and holidays. Business-day mode skips Saturdays and Sundays plus any blocked dates you list. Months and years use calendar arithmetic with end-of-month clamping, so March 31 plus one month becomes April 30. Business-day mode supports days and weeks only, where one business week equals five business days. In business mode, a nonworkday need-by date shifts backward to a workday; a nonworkday order date shifts forward. The effective anchor is excluded when counting, even for a zero-day lead time. Between-date mode excludes the start and includes an eligible end date without rolling either endpoint.
Mode functions:
- Order by date applies the first formula. You give the need-by date and lead time, and the calculator subtracts to find when to release the order.
- Expected delivery applies the second formula. You give the order date and lead time, and the calculator adds to find when goods should arrive.
- Lead time between dates applies the third formula. You give two dates, and the calculator returns the gap in calendar days or business days.
Illustrative Lead Times and Buffers
These hypothetical planning examples are not market reference values or recommended buffers. Use supplier-confirmed lead times, applicable delivery terms and your own risk assessment.
| Category | Illustrative Lead Time | Illustrative Buffer |
|---|---|---|
| Office supplies, stocked | 2 to 5 days | 2 days |
| MRO parts, domestic | 1 to 3 weeks | 1 week |
| Custom-fabricated parts | 4 to 12 weeks | 2 weeks |
| Electronics, allocated | 12 to 52 weeks | 4 weeks |
| Capital equipment | 3 to 9 months | 1 month |
| Ocean freight, overseas | 6 to 10 weeks | 2 weeks |
| Air freight, overseas | 5 to 10 days | 3 days |
| Public bid response window | 2 to 4 weeks | 3 days |
Lead time can have several components. The hypothetical percentage ranges below illustrate categories only; they are not universal shares and need not add to 100%. Establish actual components from the supplier and your process.
| Component | What It Covers | Illustrative Share |
|---|---|---|
| Internal approval | Requisition, sign-off, PO release | 5 to 15% |
| Order processing | Vendor acknowledgment, scheduling | 5 to 10% |
| Manufacturing or pick | Production, kitting, QC | 40 to 70% |
| Transit | Shipping, customs, last mile | 15 to 35% |
| Receiving | Unload, inspect, put-away | 2 to 5% |
Worked Examples
Example 1, finding the order date. A part is needed on March 15, 2026. The vendor quotes a 6-week lead time. Set the need-by date to March 15, lead time to 6, unit to weeks, count method to calendar days. The procurement date is February 1. Release the PO on or before that date.
Example 2, finding the delivery date in business days. You release a PO on October 6, 2026, with a 20-business-day lead time and no blocked holidays. Set order date to October 6, lead time to 20, unit to days, count method to business days. The expected delivery is November 3, with weekends excluded.
Example 3, measuring a bid window. A solicitation is posted June 2, 2026, with bids due June 23, 2026, and no blocked holidays. Use the lead time mode. Calendar lead time is 21 days. Business lead time is 15 days. That tells you how long you have to assemble pricing and a response.
FAQ
Should I use calendar days or business days? Use business days when the work itself only happens on weekdays, like internal approvals, vendor production at a single facility, or domestic ground transit. Use calendar days for ocean freight, long lead manufacturing, and any countdown that does not pause on weekends.
How do I handle holidays? Add them to the blocked dates field, separated by commas, in YYYY-MM-DD format. The calculator skips them in business-day mode the same way it skips weekends.
What if a vendor lead time is in months but I want business-day accuracy? Confirm a precise day count and working calendar with the supplier. Calendar months vary in length and holiday schedules; there is no fixed conversion from a month to business days.
Why does the result shift when I switch from calendar to business mode? Calendar mode counts straight days. Business mode counts only Monday through Friday and any non-blocked dates, so 10 business days from Monday lands on the Monday two weeks later, not on Wednesday of the same week.
How much buffer should I add? Use supplier-specific variability, the cost of late delivery and your required service level to choose a buffer. Historical worst cases do not guarantee a future delivery date.
